Projects rarely fall apart in one dramatic moment — they fray at the edges, one missed dependency or under-resourced task at a time. OmniPlan Pro for Mac exists to keep you ahead of that drift, giving you the tools to map out what needs to happen, in what order, and with what resources.

Where should a newcomer start?

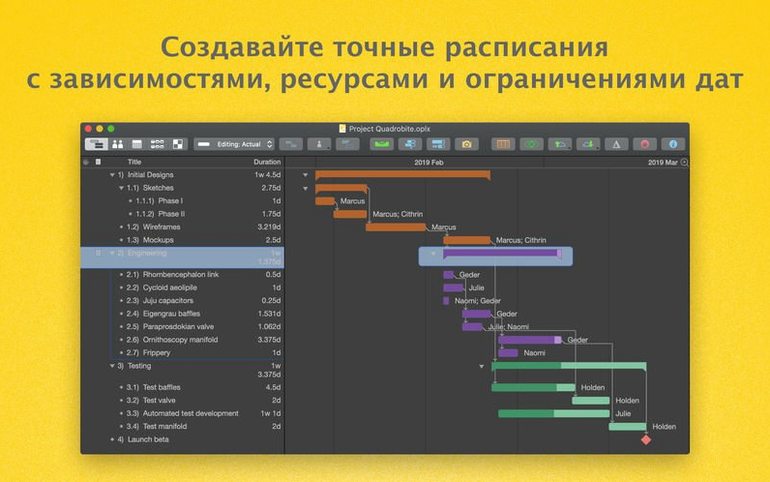

Open or import a project and head straight to the Gantt view. It lays out every task against a timeline, so you can drag dependencies between them and immediately see the critical path the app calculates. Moving a single milestone here teaches you more about the software's logic than any tour.

How does the Pro version differ from the standard one?

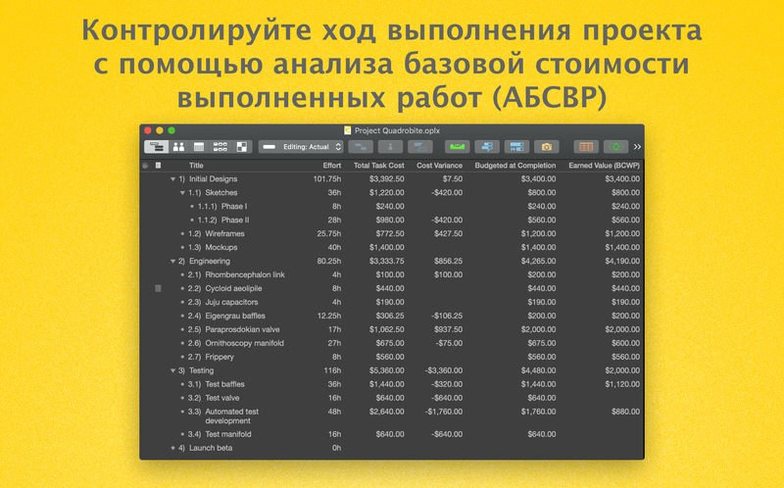

The Pro edition adds three tools aimed at serious project control: change tracking to review and accept edits, automatic effort estimation based on task parameters, and earned value analysis that compares planned progress against actual work completed.

What makes change tracking useful for a team?

When a colleague adjusts durations or reassigns resources, the change tracking in OmniPlan Pro highlights every alteration. You can then accept or reject modifications one at a time, or process all of them at once, which keeps a single source of truth intact when multiple people touch the plan.

One of the first things to do after a clean install is to set up a working calendar that reflects real absences. By default, OmniPlan assumes every weekday is available, but adding public holidays, team vacation blocks and recurring off-days before you place a single task prevents the schedule from looking optimistic in ways reality will punish later. A second early win: define resource availability as percentages rather than full-time defaults — a lead developer who splits time across two projects should show as 50% from day one, not 100% corrected later.

Where new users typically trip themselves up

The most common early mistake is treating effort and duration as interchangeable. Dragging a task bar to three days and assuming that equals 24 hours of work ignores the resource units assigned; OmniPlan calculates effort from the combination, and a mismatch here cascades through the entire project. Another frequent stumble is over-linking tasks with dependencies. Not every task needs a predecessor — some can float — and chaining everything into one rigid sequence removes the scheduling flexibility the engine is designed to exploit.

Beginners also tend to ignore the network diagram view entirely, relying on the Gantt chart for everything. That view reveals orphaned tasks and dependency knots that the timeline obscures, and checking it once after laying out a phase catches structural errors before they inflate the critical path.

A production manager's Wednesday morning

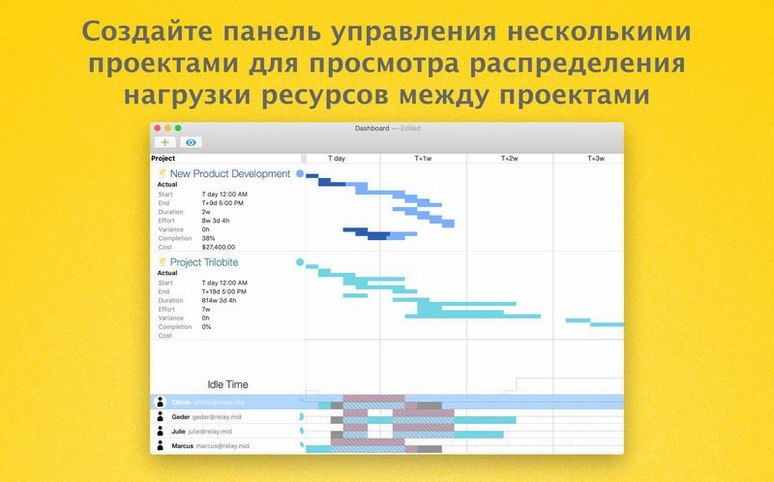

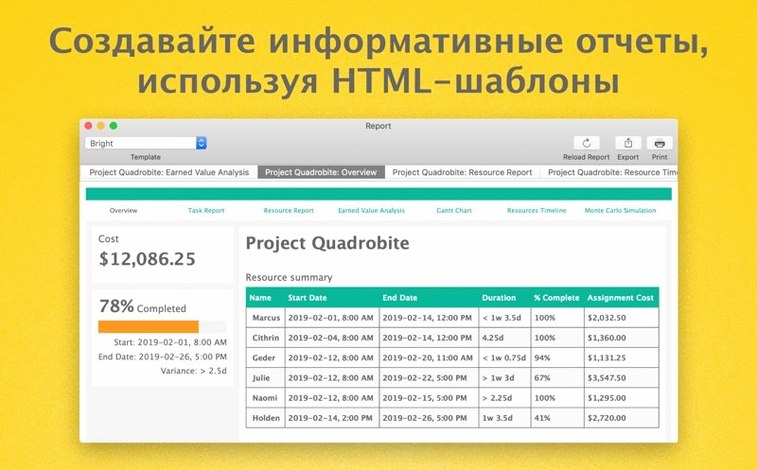

Consider a production manager at a mid-size agency who oversees three video projects simultaneously. On Wednesday morning, she opens OmniPlan Pro's multi-project dashboard and notices that one editor is assigned to two tasks that overlap by four hours, thanks to a schedule shift on a client job. Rather than manually untangling assignments across separate files, she adjusts the resource allocation in the dashboard and watches the Monte Carlo simulation recalculate a confidence range for the affected milestone — it drops from 85% to 62%, flagging the risk before anyone has logged a billable hour that day. She exports an HTML report for the account lead and publishes the updated plan through Omni Sync Server, so the editor sees the revised workload before lunch.

Version
4.11.0
Download
100 MB
Developer
The Omni Group
Languages
Russian, English, German, Spanish, Italian, Chinese (Simplified), Korean, Dutch, Portuguese, French, Japanese
Activation
K'ed by TNT team
Compatibility
macOS 11 or later
Architecture
Apple Silicon, Intel 64-bit

Questions readers asked

Yes, it supports importing and exporting Microsoft Project documents, which helps when sharing plans with colleagues who use Windows-based tools.

It does. You can assign calendars to individual resources, define working hours, and account for holidays or time off, so schedules reflect actual availability.

Letters to the desk 0

Sign in or open a desk account to write a letter.

No letters on this brief yet. They are read before they run.
